A value stream mapping example follows one product family from the supplier to the customer and puts a number on every step: cycle time, changeover, uptime and the stock waiting in front of it. Adding up the waiting gives the lead time, adding up the work gives the process time, and the gap between the two shows where to improve first.
The gap is usually huge. In the Lean Enterprise Institute workbook Seeing the Whole Value Stream, the authors show that nearly 90% of the actions and 99.9% of the time in a typical supply chain’s current state create no value. Below are three worked examples from manufacturing, machining, assembly and injection moulding, each with a current state, a future state and the full calculation.
- Lead time = stock in front of each step divided by daily demand, added up along the map.
- Process time = the cycle times of the steps that change the product, added up.
- Value added ratio = process time divided by lead time, both in seconds.
- A step whose cycle time divided by uptime is above takt time is the bottleneck.
What is a value stream map?
A value stream map is a one-page drawing of every step needed to bring one product family from order to delivery, with the material flow, the information flow and the data of each step. It shows how long the product waits and how long it is worked on, so the team can fix the whole flow instead of one machine.
Toyota developed the tool as a material and information flow diagram within the Toyota Production System, as the Lean Enterprise Institute lexicon explains. Mike Rother and John Shook made it widely known with the workbook Learning to See, a Shingo Research Prize recipient in 1999, which describes the map as a paper-and-pencil representation of every process with its key data. A mapping project produces two maps: the current state, as the flow runs today, and the future state, a target for the next 6 to 12 months, followed by a plan.
How do you calculate lead time, process time and value added on a VSM?
Five formulas cover most value stream maps. Convert all times to seconds and use the same available working time per day for takt time and for the lead time, otherwise the value added ratio is wrong by a factor of two or three.
| Metric | Formula | What it tells you |
|---|---|---|
| Takt time | Available working time per day / customer demand per day | How often one part must be finished |
| Days of stock | Pieces in stock / customer demand per day | How long a part waits in that triangle |
| Lead time | Sum of the days of stock along the map | How long a part needs from raw material to shipping |
| Process time | Sum of the cycle times of the steps that change the product | How long the part is worked on |
| Value added ratio | Process time / (lead time in days multiplied by working seconds per day) | Share of the lead time that adds value |
| Effective cycle time | Cycle time / uptime | Real capacity of a step; above takt time means a bottleneck |
The ladder along the bottom of the map holds both sums: the days of stock on the upper steps and the cycle times on the lower steps. Readers of the map look at the two totals at the right end of the ladder first.

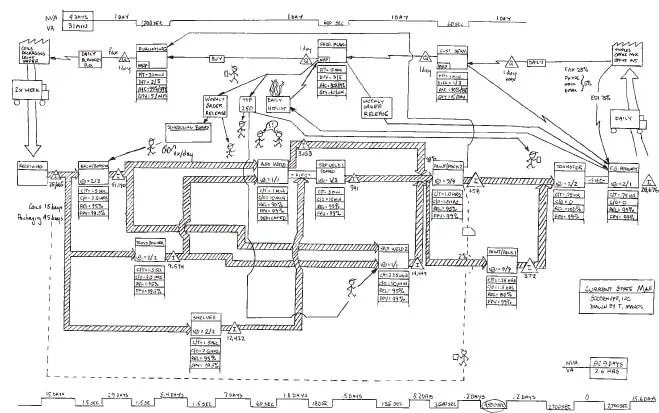

Value stream mapping example 1: CNC machining
The first illustrative example is a machined steel shaft for a hydraulic pump. The plant works 2 shifts of 460 minutes, so 55,200 seconds a day, and the customer needs 460 shafts a day. Takt time is 55,200 / 460 = 120 seconds. Material is pushed from the saw through turning, milling, deburring and final inspection.
| Step | Cycle time | Changeover | Uptime | Stock in front |
|---|---|---|---|---|
| Saw | 30 s | 15 min | 98% | 6 days of bar stock |
| CNC turning | 95 s | 90 min | 85% | 2 days |
| CNC milling | 110 s | 60 min | 80% | 3 days |
| Deburr and wash | 40 s | 10 min | 96% | 1 day |
| Final inspection | 25 s | – | – | 0.5 day |
| Shipping | – | – | – | 4 days of finished shafts |
Lead time is 6 + 2 + 3 + 1 + 0.5 + 4 = 16.5 days, which is 910,800 working seconds. Process time is 30 + 95 + 110 + 40 + 25 = 300 seconds. A shaft is worked on for about 1 second in every 3,000 it spends in the plant.
Milling looks fine at 110 seconds, but its effective cycle time is 110 / 0.80 = 137.5 seconds, above the takt of 120. That is why the plant runs Saturday shifts and why 3 days of shafts wait in front of milling. Turning is close behind at 95 / 0.85 = 112 seconds. Our guide to the theory of constraints shows how to work on a bottleneck like this one.
Future state for the machining example
The future state attacks the bottleneck and the stock. A TPM routine on the spindle and coolant faults raises milling uptime from 0.80 to 0.90, and moving the edge deburring to the wash station cuts milling to 100 seconds: 100 / 0.90 = 111 seconds, below takt. SMED cuts the turning changeover from 90 to 30 minutes, so smaller batches are possible.
| Item | Current state | Future state | Kaizen burst |
|---|---|---|---|
| Milling effective cycle time | 137.5 s | 111 s | TPM on spindle, edge deburr moved to wash |
| Turning changeover | 90 min | 30 min | SMED workshop |
| Bar stock | 6 days, pushed | 3 days, supplier kanban | Supermarket for raw material |
| Saw to milling | 5 days, pushed | 1 day in two FIFO lanes | FIFO lanes with a fixed maximum |
| Milling to inspection | 1.5 days | 0, one-piece flow cell | Cell for milling, deburr and inspection |
| Finished shafts | 4 days | 2 days | Finished goods supermarket |
| Lead time | 16.5 days | 6 days | – |
| Value added ratio | 0.033% | 0.091% | – |
Process time stays at 300 seconds, because the work content did not change. Lead time falls from 16.5 to 6 days only because parts wait less. This is the normal pattern of a first future state.

Value stream mapping example 2: assembly line
The second illustrative example is a manual assembly line for an electric seat actuator. The plant works 2 shifts, 55,200 seconds a day, and the customer calls off 920 actuators a day, so takt time is 60 seconds. Planning sends a separate weekly schedule to each station, and kits come from the warehouse once a day.
| Step | Cycle time | Uptime | Stock in front |
|---|---|---|---|
| Kitting in the warehouse | 35 s | – | 8 days of purchased parts |
| Gear sub-assembly | 52 s | – | 1 day of kits |
| Main assembly | 68 s | – | 1.5 days of sub-assemblies |
| End-of-line test | 45 s | 92% | 0.5 day |
| Packing | 20 s | – | 0.25 day |
| Shipping | – | – | 3 days of finished actuators |
Lead time is 8 + 1 + 1.5 + 0.5 + 0.25 + 3 = 14.25 days, or 786,600 working seconds. Process time is 35 + 52 + 68 + 45 + 20 = 220 seconds. Main assembly needs 68 seconds against a takt of 60, so the line can only keep up with overtime, while the test bench, at 45 / 0.92 = 49 seconds, waits for parts.
The line has enough people; the work is badly balanced. The manual work on the line is 52 + 68 + 20 = 140 seconds, enough for 3 manual stations below takt if the work is spread evenly. A yamazumi chart, a stacked bar of the work elements per station, shows which tasks can move.
| Item | Current state | Future state | Kaizen burst |
|---|---|---|---|
| Station cycle times | 52 / 68 / 20 s | 55 / 55 / 30 s | Rebalance with a yamazumi chart |
| Material supply | Daily kits from the warehouse | Water spider every 60 minutes | Line-side supermarket, milk run |
| Purchased parts | 8 days | 4 days | Daily supplier call-offs |
| Between stations | 3.25 days | 0.25 day, one-piece flow | Join stations into one cell |
| Finished actuators | 3 days | 2 days | Schedule only the packing step |
| Lead time | 14.25 days | 6.25 days | – |
| Value added ratio | 0.028% | 0.064% | – |
In the future state, planning sends the customer schedule only to the last step, the pacemaker, and a levelled mix, as described in our article on heijunka, keeps the pull system stable.
Value stream mapping example 3: injection moulding
The third illustrative example is a plastic clip housing made on a 4-cavity mould. One shot takes 32 seconds, so the press gives one part every 8 seconds. The plant works 3 shifts, 82,800 seconds a day, the customer needs 4,800 clips a day, and takt time is 82,800 / 4,800 = 17.25 seconds.
| Step | Cycle time | Changeover | Uptime | Stock in front |
|---|---|---|---|---|
| Injection moulding | 32 s shot, 8 s per part | 90 min | 85% | 10 days of resin |
| Spring insertion | 10 s | – | – | 9 days of moulded parts |
| Packing | 3 s | – | – | 1 day |
| Shipping | – | – | – | 4 days of finished clips |
Lead time is 10 + 9 + 1 + 4 = 24 days, or 1,987,200 working seconds. For process time, count the 32 seconds a part spends in the mould, since the 8 seconds per part is only the press output rate: 32 + 10 + 3 = 45 seconds. A clip is worked on for 1 second in about 44,000.
The press is not the bottleneck: 8 / 0.85 = 9.4 seconds per part, well below takt. The stock comes from changeovers. Six parts share the press, and at 90 minutes each a daily cycle of all six would cost 540 of the 1,380 minutes a day. So the plant runs every part once in 2 weeks, an EPEI (every part every interval) of 10 days, and the batch waits in front of assembly.
Moulding maps can carry a second line under the time ladder. The EPA Lean and Environment Toolkit suggests a materials line showing the resin, energy or scrap of each step, which makes purge losses at every changeover visible.
| Item | Current state | Future state | Kaizen burst |
|---|---|---|---|
| Changeover | 90 min | 25 min | SMED: preheated mould, quick clamps, mould cart |
| EPEI | 10 days | 2 days | Fixed changeover wheel for the six parts |
| Resin | 10 days | 4 days | Weekly resin call-off |
| Moulded parts | 9 days | 2 days in a supermarket | Kanban from assembly to the press |
| Assembly to packing | 1 day | 0, cell next to the press | Move spring insertion to the press |
| Finished clips | 4 days | 1.5 days | Finished goods supermarket |
| Lead time | 24 days | 7.5 days | – |
| Value added ratio | 0.0023% | 0.007% | – |
With 25-minute changeovers, six changeovers cost 150 minutes a day, so every part can run every second day and the supermarket only needs 2 days of stock.
What do the three examples show?
All three maps show the same thing: process time hardly changes from current to future state, and lead time falls because stock is cut. Each example needed a different lever: uptime and a bottleneck in machining, line balance in assembly and changeover time in moulding.
| Example | Takt and process time | Lead time now | Lead time future | Main lever |
|---|---|---|---|---|
| CNC machining | 120 s / 300 s | 16.5 days | 6 days | Bottleneck uptime, FIFO lanes |
| Assembly line | 60 s / 220 s | 14.25 days | 6.25 days | Line balancing, milk run |
| Injection moulding | 17.25 s / 45 s | 24 days | 7.5 days | SMED, shorter EPEI |
Published case studies report gains of the same order. A 2022 automotive case study reports that the lead time of the process improved by 67%. A 2014 study of a vehicle component line reports that production lead time and value added time improved by nearly 80% and 12%.
The interim management guide for manufacturing companies
When an experienced interim manager is the fastest way to stabilize production and get results that last.
- When an interim manager pays off
- How to write a mandate
- The first 30 days, week by week
Which symbols are used in a value stream map?
A value stream map uses a small set of standard icons. The Lean Enterprise Institute describes three rows: the information flow at the top, the process steps with their data boxes in the middle, and the timeline with the summary data at the bottom. Customer and supplier sit in the upper corners.
| Symbol | What it shows |
|---|---|
| Customer or supplier (factory icon) | Outside company, with its demand or delivery data |
| Process box with data box | One step: cycle time, changeover, uptime, operators, shifts |
| Inventory triangle | Stock waiting between two steps, in pieces and days |
| Push arrow (striped) | Material pushed to the next step on a schedule |
| Supermarket | Controlled stock from which the next step takes what it needs |
| FIFO lane | Limited queue worked first in, first out |
| Kanban post and signal | Card or signal that authorises production or withdrawal |
| Truck shipment | Delivery to the customer or from the supplier, with frequency |
| Electronic and manual information arrows | How orders and schedules reach each step |
| Kaizen burst | An improvement needed to reach the future state |
| Timeline ladder | Days of stock and process times, with the totals |
How do you create a value stream map step by step?
Most plants map a value stream in four steps run by a cross-functional team of 7 to 10 people: choose the product family, draw the current state on the shop floor, design the future state and write the plan. A focused three-day workshop is usually enough for the maps and a draft plan.

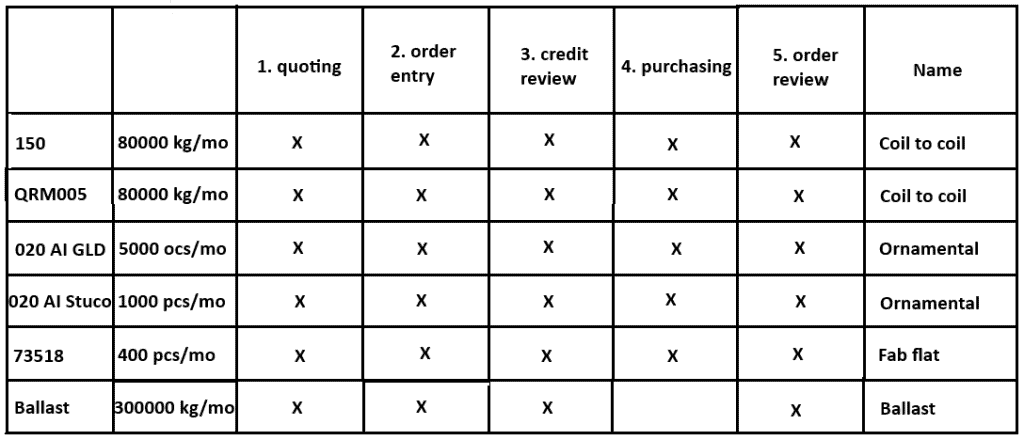

- Choose the product familyList parts against processing steps in a matrix and group the parts that share most steps. Map one family, door to door.
- Draw the current stateWalk the flow from shipping back to receiving, count the stock, time the steps and note how orders reach each step.
- Design the future stateWork out takt time, the bottleneck, where parts can flow, where a supermarket or FIFO lane is needed and which step gets the schedule.
- Write and run the planTurn every kaizen burst into a project with an owner, a date and a monthly review, then redraw the current state.
| Day | Activities | Output |
|---|---|---|
| Day 1 | Product family matrix, walk the flow, collect data | Selected family, data sheets |
| Day 2 | Draw the current state map and the time ladder | Current state map |
| Day 3 | Draw the future state map, draft the plan | Future state map, draft plan |
Data that is roughly right is enough to start. If an operator says the press stops about four hours a week, use that. Measure only the numbers the team doubts or disagrees on.
How is value stream mapping used in logistics?
In logistics, the value stream map follows an order or a pallet instead of a part: from the supplier’s dock to the plant, or from the customer order to the loaded truck. The same icons apply, with trucks, milk runs and warehouse steps, and the waiting is usually in batches of orders and fixed truck times.
| Step | Process time | Waiting in front (current) | Waiting in front (future) |
|---|---|---|---|
| Order release to picking | 1 min | 4 h, one picking wave per shift | 1 h, hourly waves |
| Picking | 6 min | – | – |
| Packing | 4 min | 2 h | 0.5 h |
| Staging and loading | 3 min | 1 day, one carrier pickup a day | 0.5 day, two pickups a day |
The touch time is 14 minutes in both states, while the order waits more than a day today. Across companies, an extended value stream map links several plants and warehouses. In Seeing the Whole Value Stream, the ideal future state lets value flow from raw materials to the customer in just 6% of the time previously needed. The same approach works for other flows: an order-to-cash process, an engineering change, a hospital patient path or a software release pipeline.
What are common mistakes in value stream mapping?
Most failed maps fail for the same reasons: the data came from the office, the scope was too wide or nobody owned the plan after the workshop. The list below covers the mistakes seen most often on manufacturing maps.
- Mapping from the office. The map shows the procedure, and the waiting times are guessed.
- Mapping the whole plant. Without a product family the map is too complex to act on.
- Leaving out the information flow. Material arrows alone do not show why parts are made too early.
- Using nameplate cycle times. Time the real cycle and divide by uptime, or the bottleneck stays hidden.
- Mixing time bases. Lead time in calendar days and takt in working seconds gives a wrong ratio.
- A future state without a plan. The map hangs on the wall and nothing changes.
Give every kaizen burst an owner and a date before the team leaves the room, and review the plan in the monthly management meeting.
Many kaizen bursts become short events of their own, such as 5S in a cell or a kaizen workshop on changeovers. Our overview of lean tools shows which tool fits which burst.
How GQ interim helps
Drawing the maps takes three days. The 6 to 12 months of change that follow, next to daily production, are where most plants need an experienced person. Since 2015 we have run 2,560+ projects in manufacturing across Central and Eastern Europe. An interim lean manager, plant manager or logistics manager can run the mapping, lead the projects and hand a working routine to your team. See also what an interim manager does.
Conclusion
A value stream mapping example is only useful with its numbers. Count the stock, time the steps, divide by uptime and compare process time with lead time. In all three examples the future state cut lead time by more than half without changing the work content, and the plan with owners and dates made it happen.
Shorten your lead time this year
Tell us which value stream needs work. We come back with lean and operations experts who have done it before.
Frequently asked questions
What is an example of value stream mapping?
A typical example is a machining line that saws, turns, mills, deburrs and inspects a shaft. The map shows each step’s cycle time, changeover and uptime, the stock between steps and how orders arrive. In our illustrative example, a shaft needs 300 seconds of work but spends 16.5 days in the plant.
What are the four steps of value stream mapping?
Choose a product family, draw the current state map on the shop floor, design the future state map and write a plan with owners and dates. Some guides add preparation and follow-up as extra steps, which gives five or more.
What are the three types of VSM?
Practitioners usually name the current state map, the future state map and the ideal state map. The current state shows the flow today, the future state is a target for the next 6 to 12 months, and the ideal state is the long-term vision with no waste.
How do I create a value stream map?
Pick one product family, walk the flow from shipping back to receiving, and draw each step with a data box, the inventory triangles, the information flow and the time ladder. Then add up lead time and process time, design the future state and plan the kaizen bursts.
What is the best tool for value stream mapping?
Paper, pencil and sticky notes on the shop floor are the best tool for the first map, because the whole team can change it quickly. For sharing and updating, teams use Visio, Lucidchart, Miro or VSM templates in Excel.
How do you calculate the value added ratio?
Divide the process time by the lead time, both in seconds. Convert the lead time with the same available working time per day used for takt time. In the machining example, 300 seconds divided by 910,800 seconds gives about 1 second of work in every 3,000.
What is the difference between cycle time and lead time on a VSM?
Cycle time is how often one step finishes a part. Lead time is how long one part needs to pass through the whole value stream, mostly spent waiting in stock. Process time, the sum of the cycle times, sits below lead time on the timeline ladder.
What is the difference between value stream mapping and process mapping?
A value stream map shows one product family end to end, with material flow, information flow and lead time. A process map shows the detailed steps and decisions inside one process. Use the value stream map to find where to act, then a process map to fix that step.
When should you use a value stream map?
Use it at the start of a lean program, before a layout change or a new line, when lead time or stock is too high, or when a customer complains about delivery. Our guide to business process improvement shows how it fits into a wider program.
